Week 44 – Whitmoor Stage 2 and 3

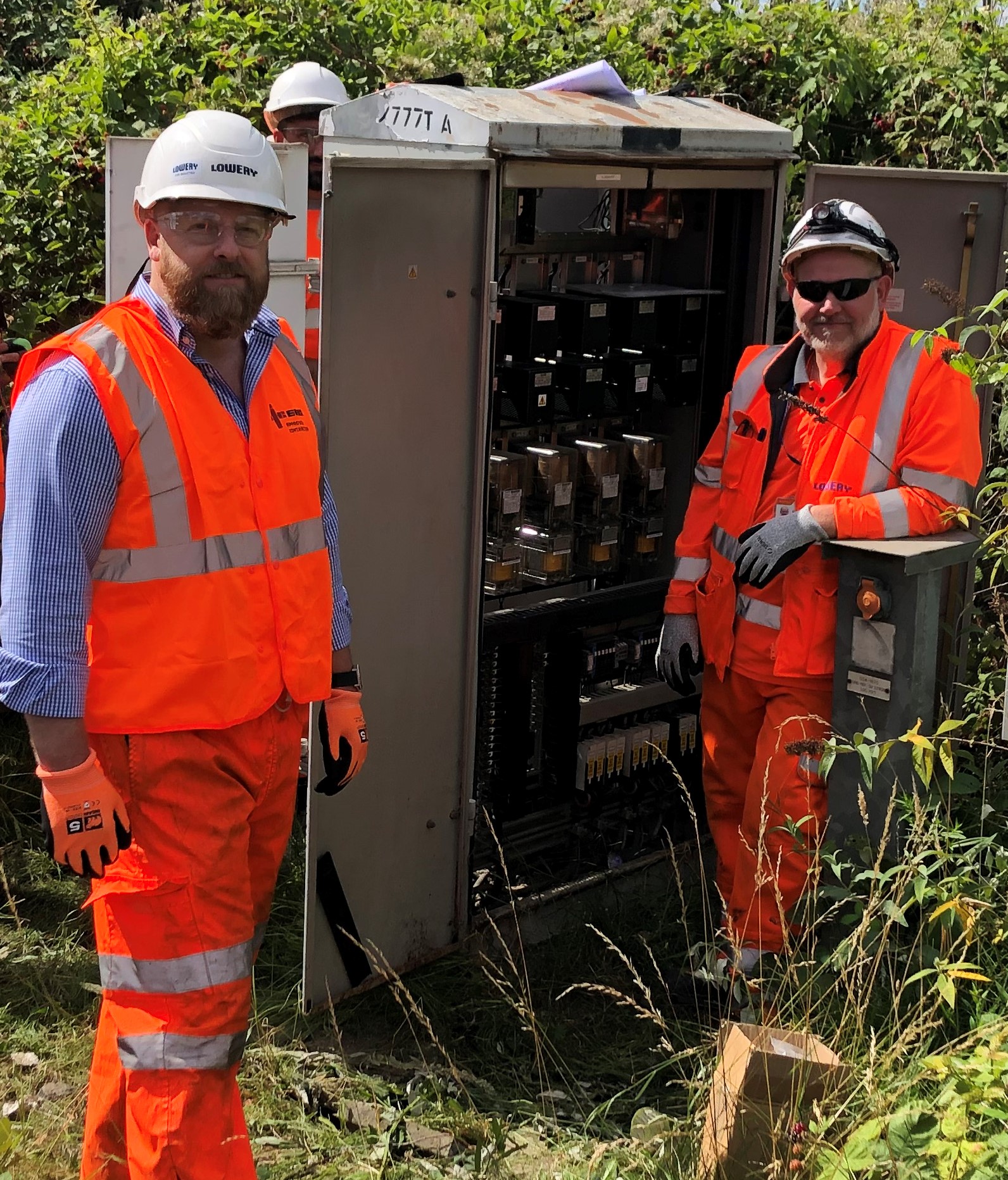

Lowery successfully completed full SCADA pre-commissioning (end to end test) and new communication unit back to control room, splitting existing feeder F2237 between Ascot and Bracknell to F2084 and F2085, Full RTU SCADA commissioning including all the alarms associated with the HV Switchgear and modules, HV protection (Line Differential Protection - Translay)
24
Mar
2017

Week 44 – Winnersh – installation of 2 advance pla
Lowery complete the full pre-commissioning of HV module, TRU module and DC module including HV, LV and DC switchgear, Transformer Rectifier unit, SCADA RTU, Battery chargers, HV, LV and DC protection settings
24
Apr
2017

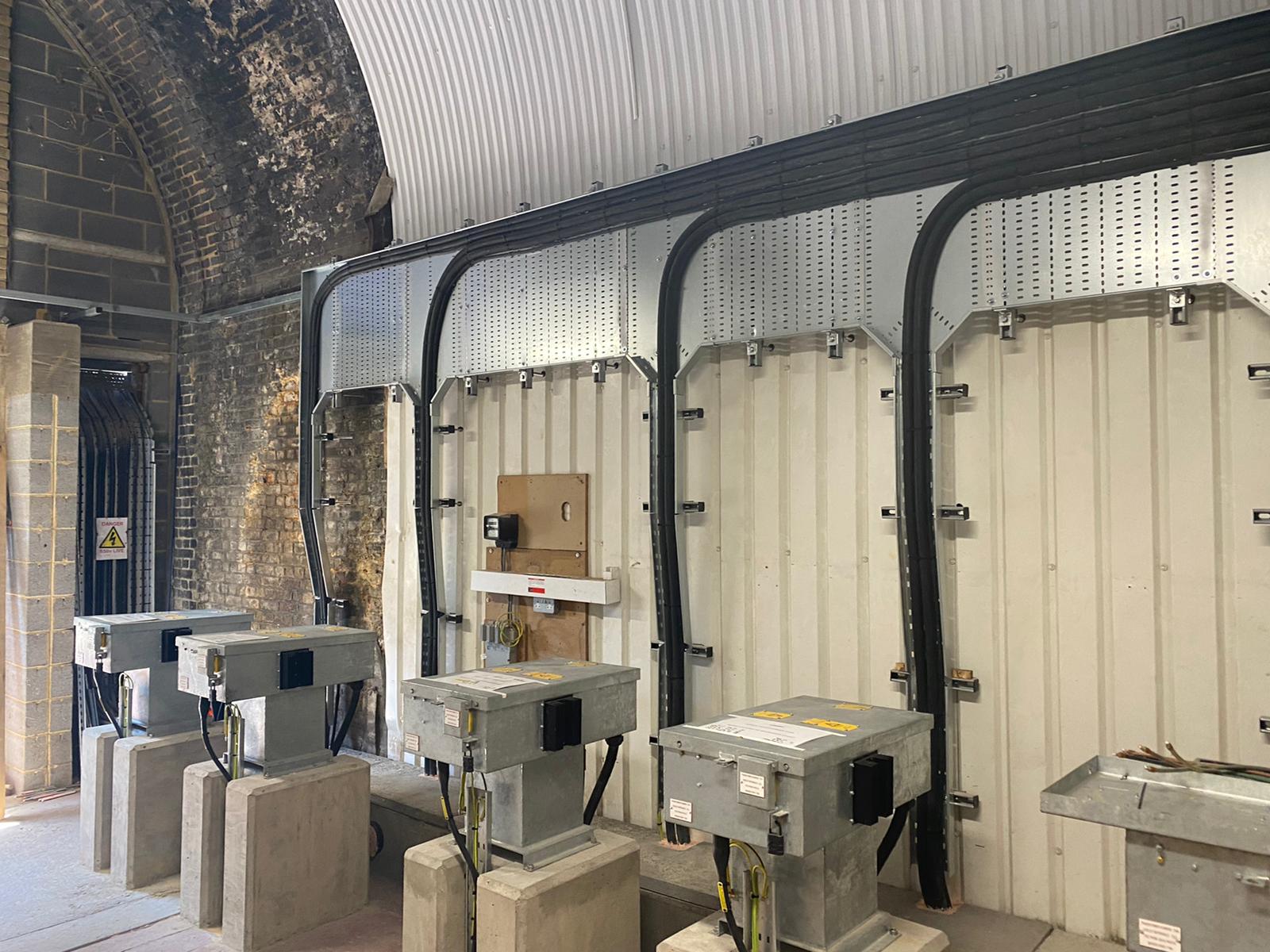

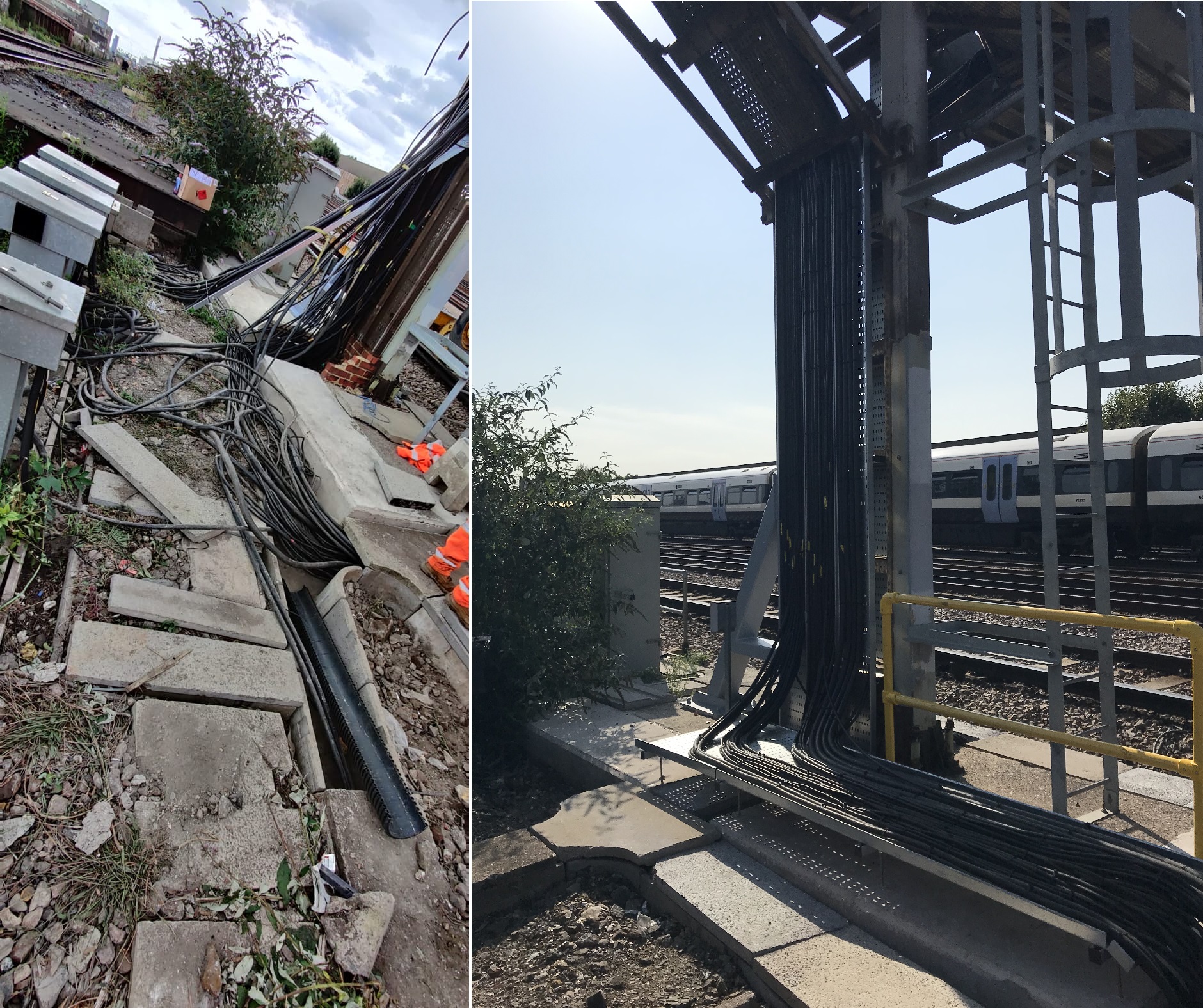

Cable Fire Remediation at Euston
Following a lineside fire just outside Euston Station Lowery carried out the emergency of repair of 4 feeders enabling the re-energisation of Euston Station.
